Procurement Toolkit

Thirty-five practical templates for every stage of the procurement and supply cycle, from the first definition of need to contract performance. Free to download, adapt and share.

New in October 2026

Supply continuity, trade policy, artificial intelligence and new EU rules now shape procurement decisions as much as price does. Ten new templates help buyers plan for them, and the original twenty-five have been updated with resilience, trade compliance and the responsible use of AI in mind.

  • AI in procurement

    Decide where AI is used and who checks its outputs, then buy AI tools on clear terms for data, security and model changes.

    Templates 26, 27, 28

  • Geopolitical and route risk

    Assess exposure to conflict, chokepoints, sanctions and tariffs, test scenarios and agree index-based price adjustment instead of ad hoc surcharges.

    Templates 29, 31, 32

  • Trade and sustainability rules

    Check sanctions, origin and forced labour risk, and collect verified emissions data for CBAM goods before award rather than at the border.

    Templates 30, 33, 34

  • Value after signature

    Check invoices against contract prices and keep track of the obligations that are easiest to lose.

    Template 35

All templates

Grouped by the stages of our approach. Word templates are documents to complete and issue; Excel templates calculate as you enter data.

Start here

  • 00Word

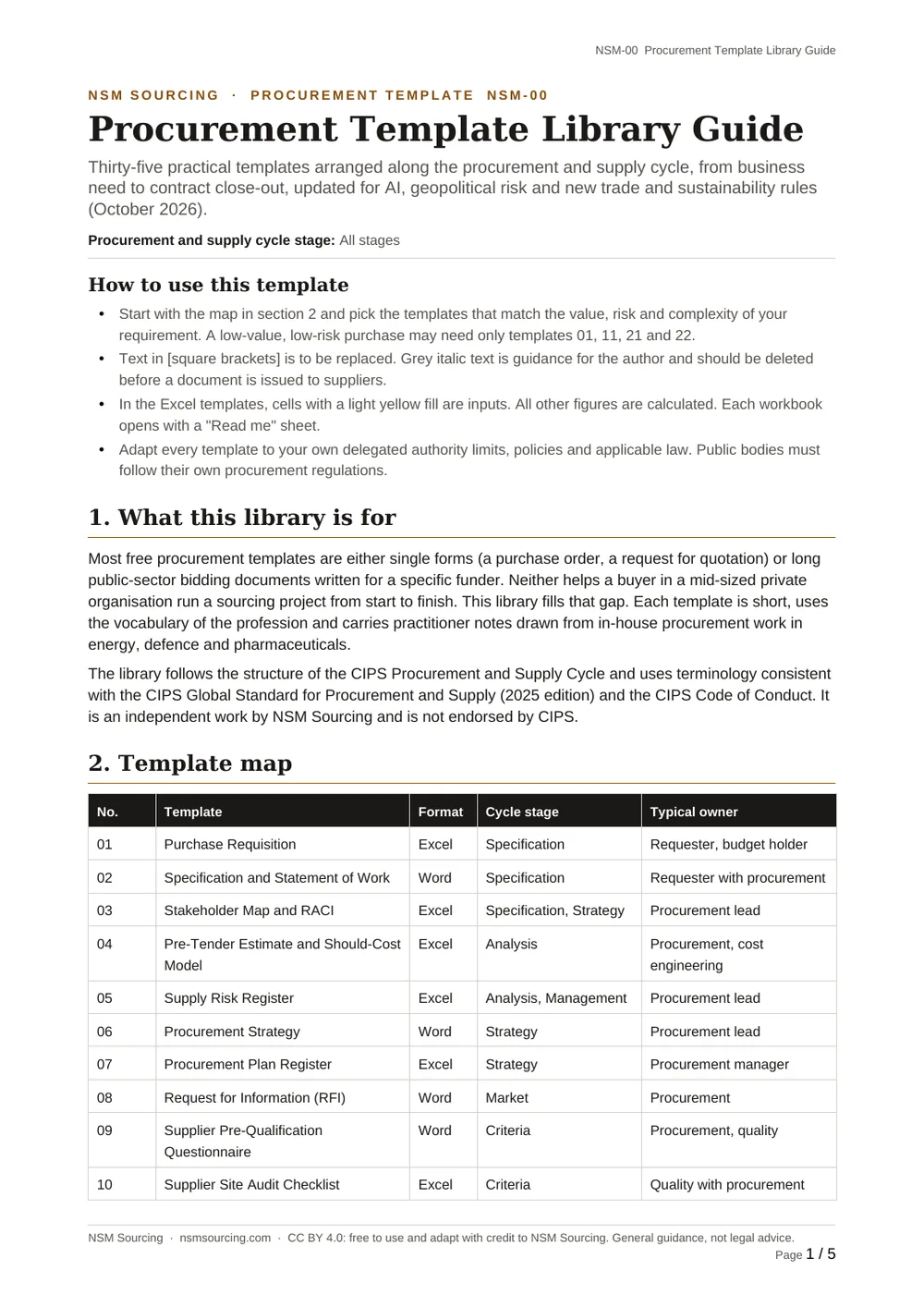

    Template Library Guide

    How the templates fit together, which to use when, and what changed in 2025 and 2026.

    Download

Define the need

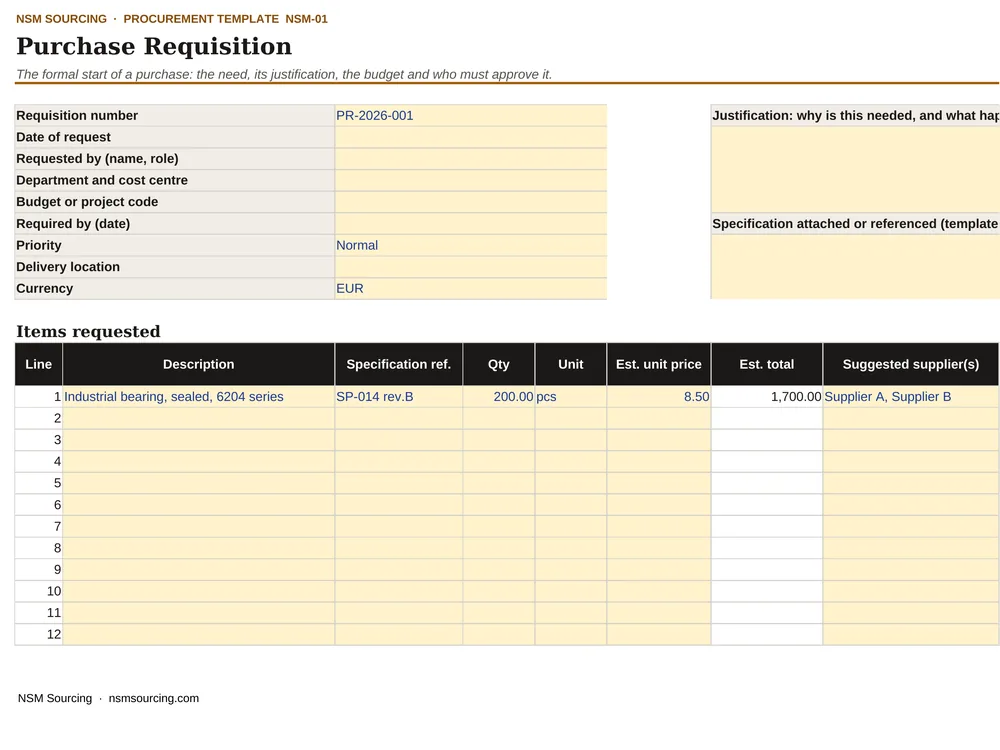

  • 01Excel

    Purchase Requisition

    Record the need, the budget and the approval before any supplier is contacted.

    Download

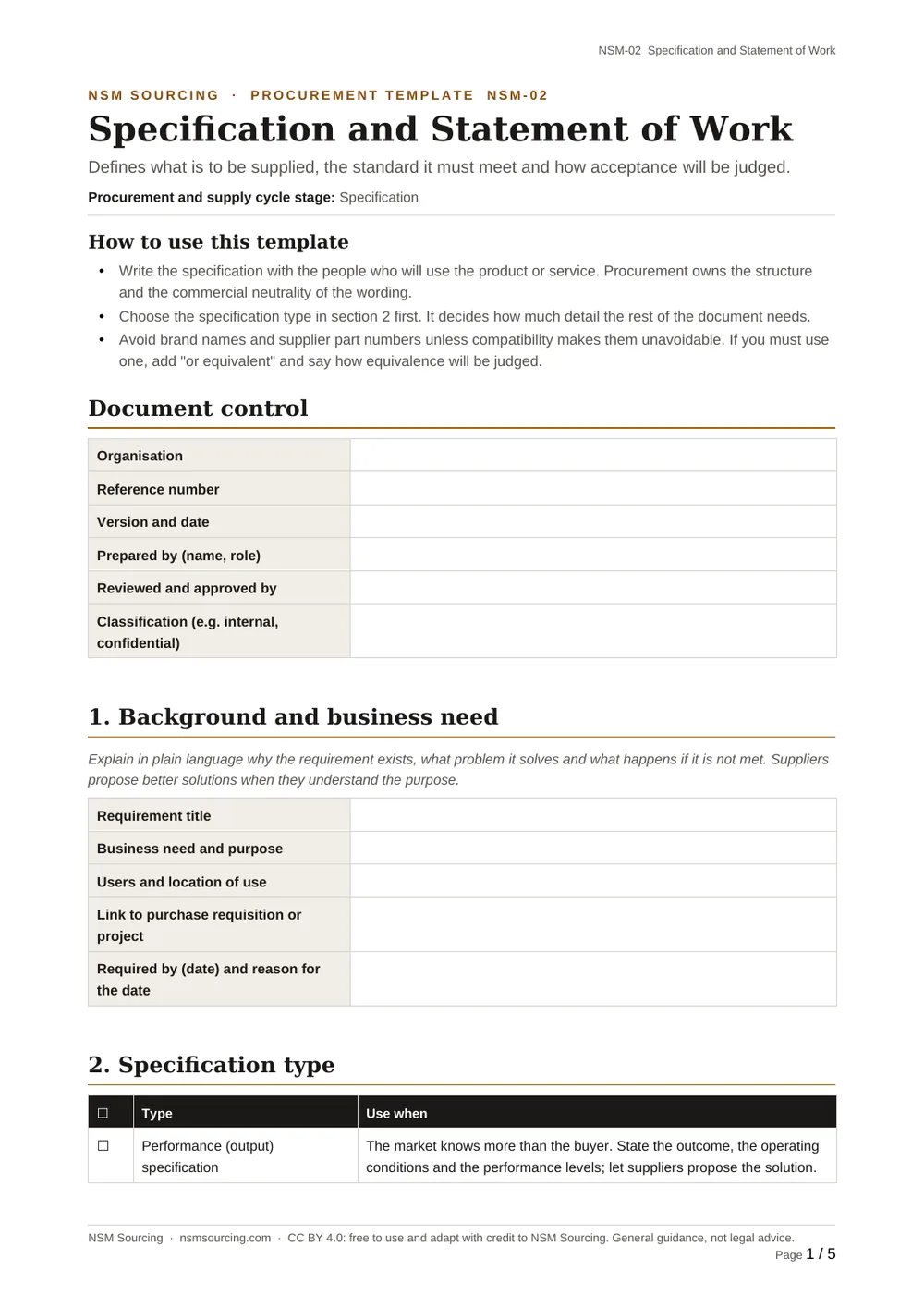

  • 02Word

    Specification and Statement of Work

    Define what is to be supplied, the standard it must meet and how it will be accepted.

    Download

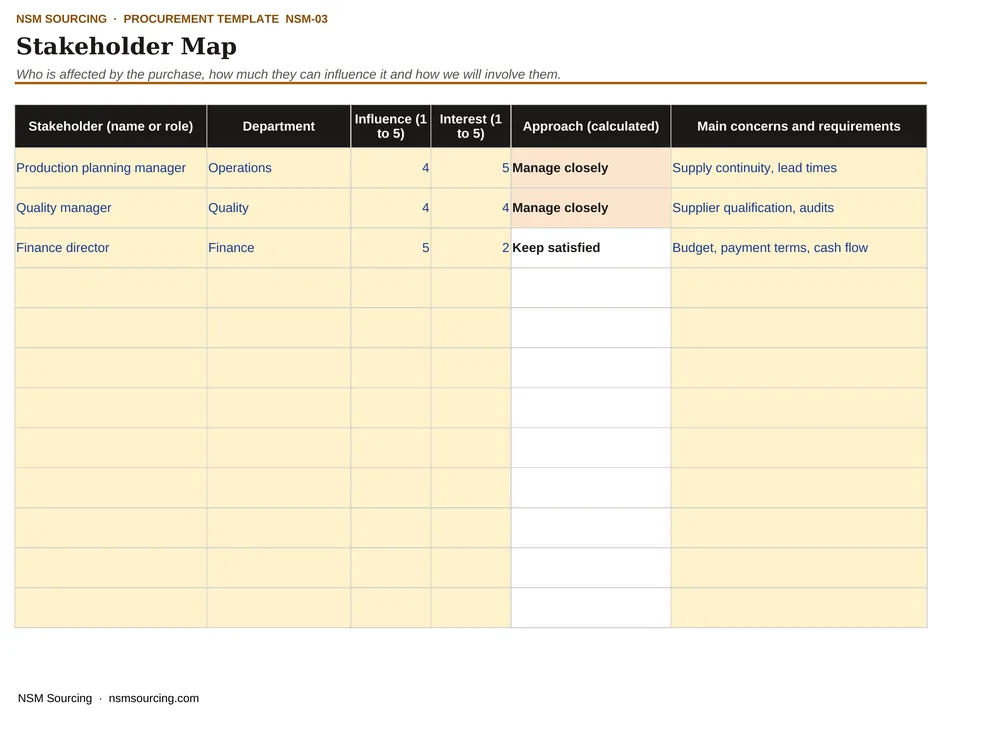

  • 03Excel

    Stakeholder Map and RACI

    Map who is affected, who decides and who must be consulted.

    Download

Analyse the market and the cost

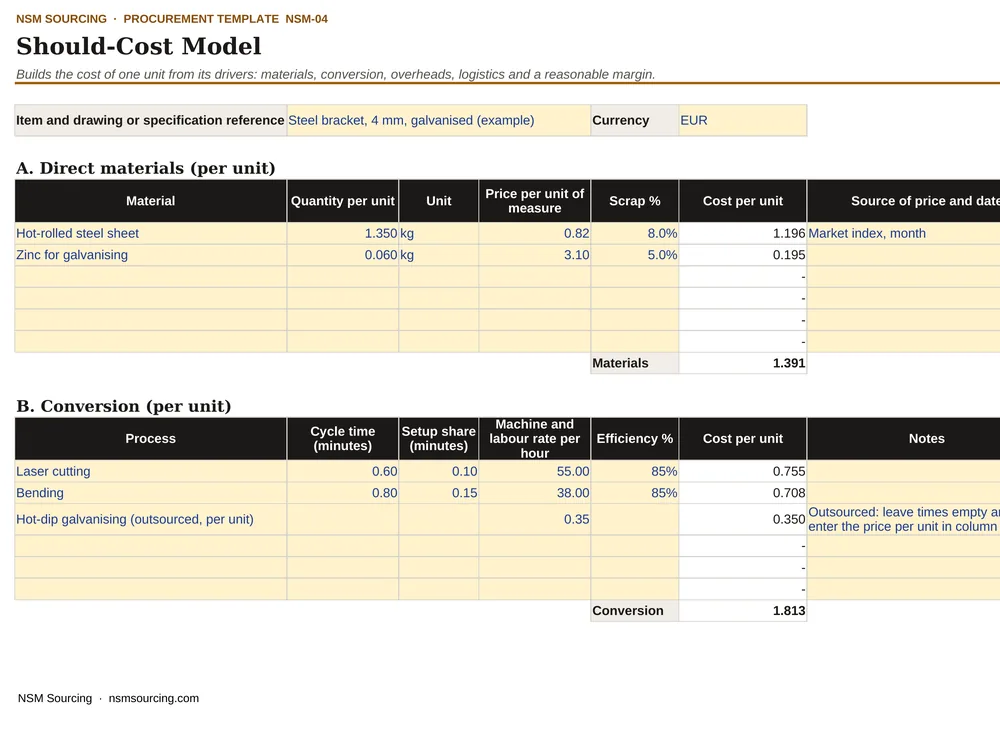

  • 04Excel

    Pre-Tender Estimate and Should-Cost Model

    Build an independent estimate from cost drivers, with energy, freight and carbon scenarios.

    Download
  • 05Excel

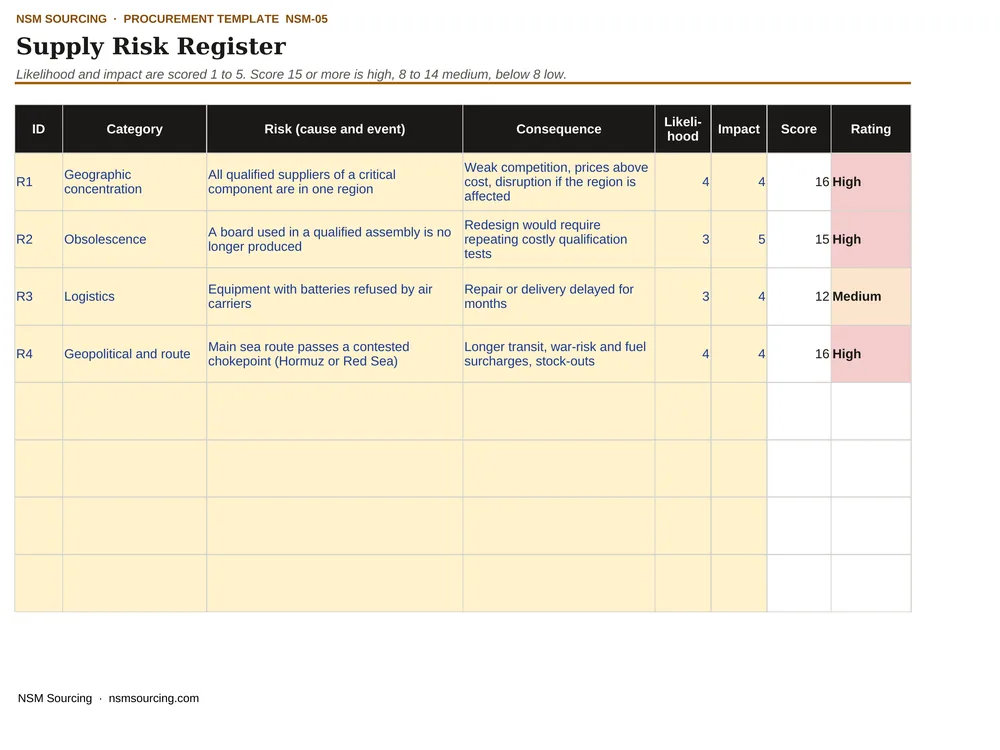

    Supply Risk Register

    Score supply risks, with early warning indicators and triggers for action.

    Download
  • 06Word

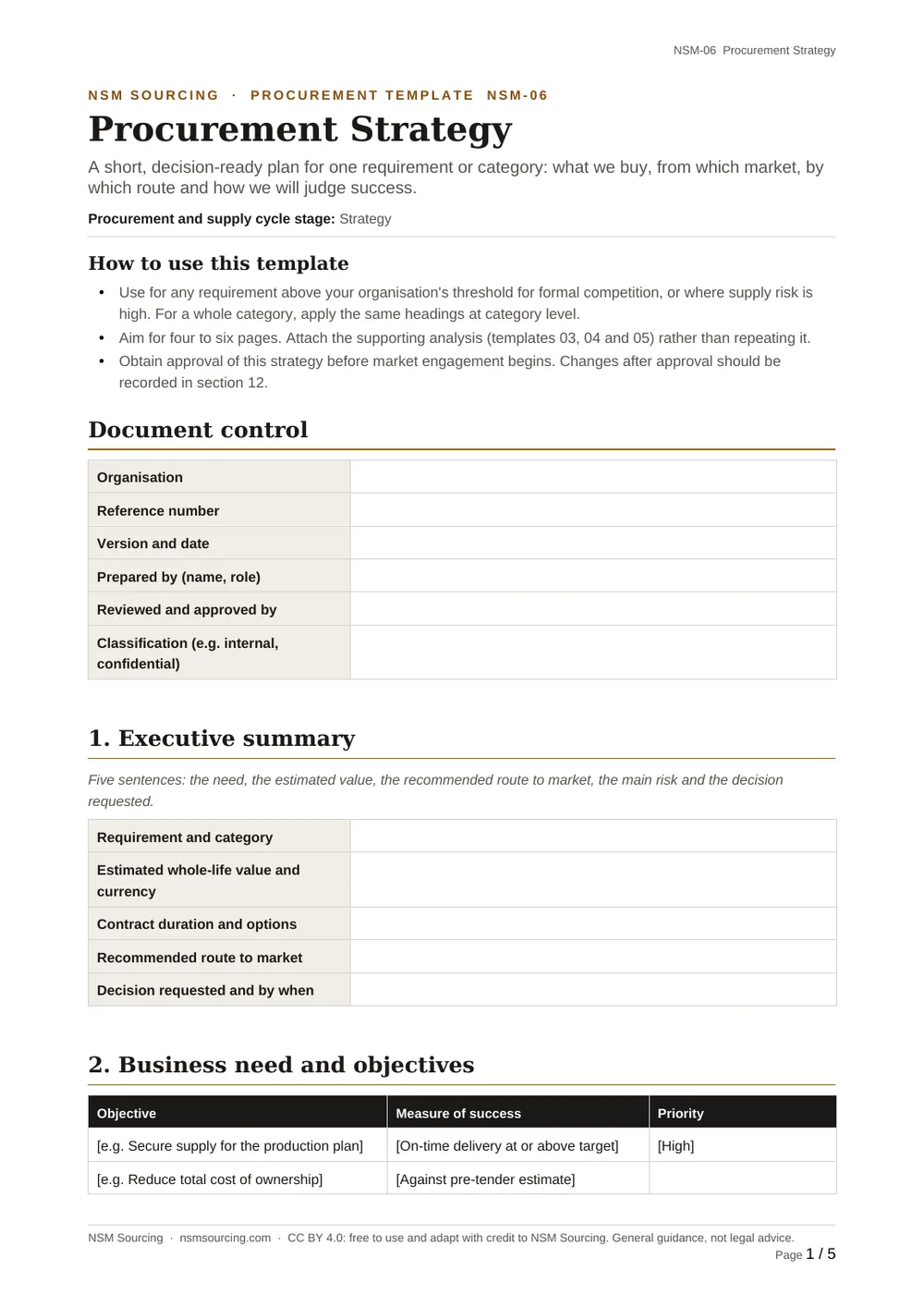

    Procurement Strategy

    A short, decision-ready plan covering the market, the method, evaluation, scenarios and risks.

    Download
  • 07Excel

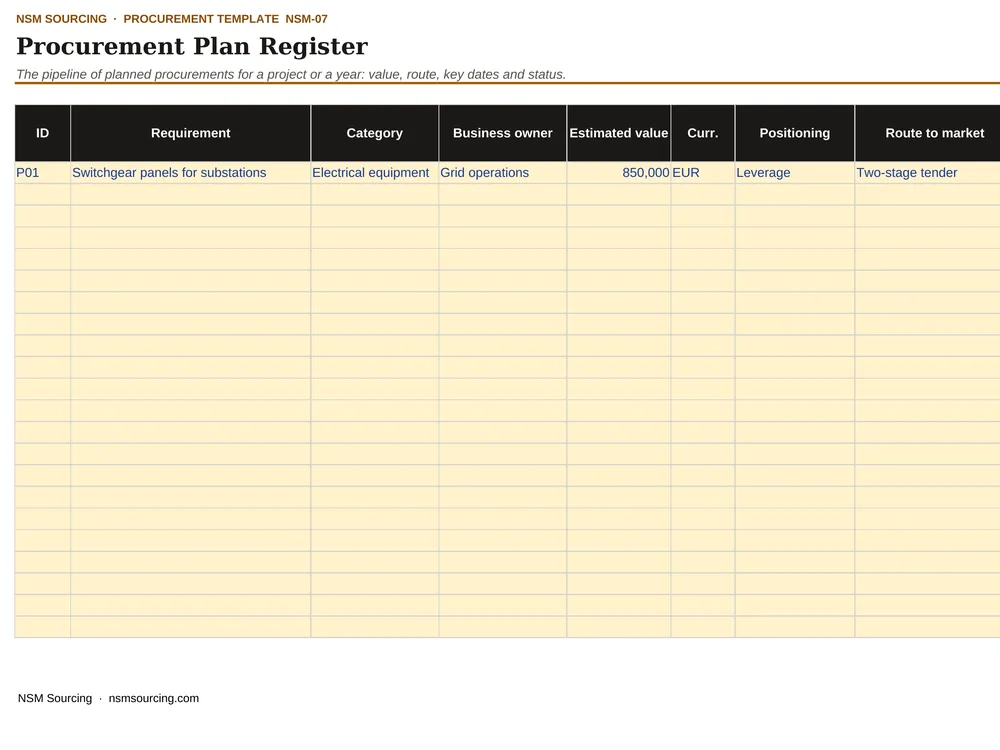

    Procurement Plan Register

    Plan the year's procurement activity, with regulatory flags and continuity-critical items.

    Download

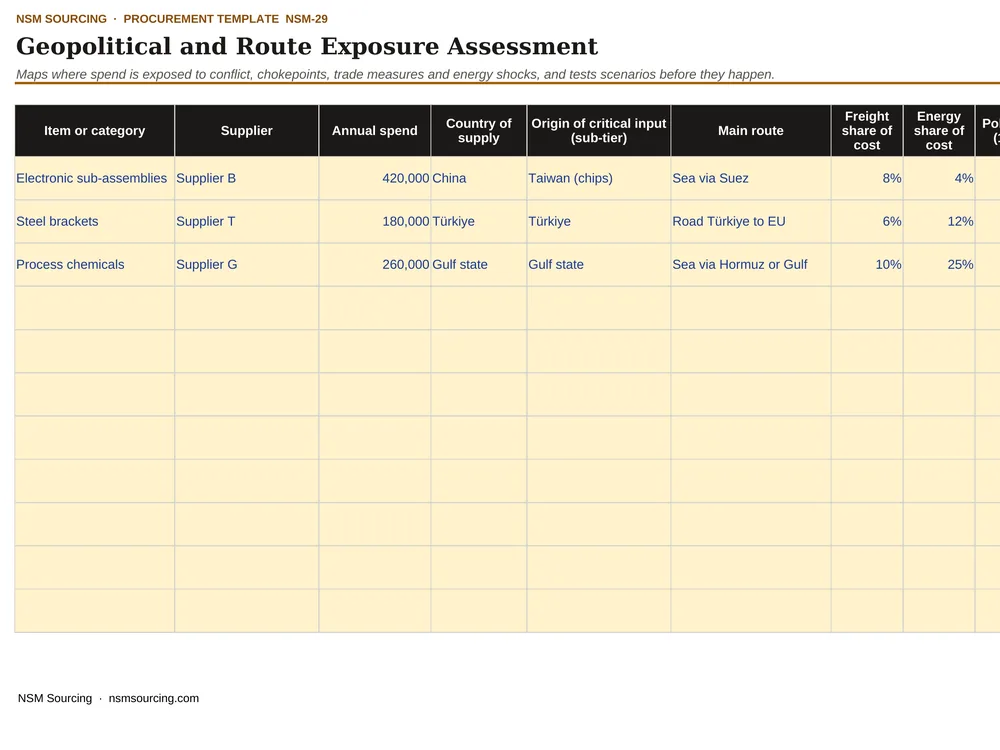

  • 29Excel

    Geopolitical and Route Exposure Assessment

    Score exposure to conflict, chokepoints, sanctions and tariffs, and test cost scenarios.

    Download
  • 31Excel

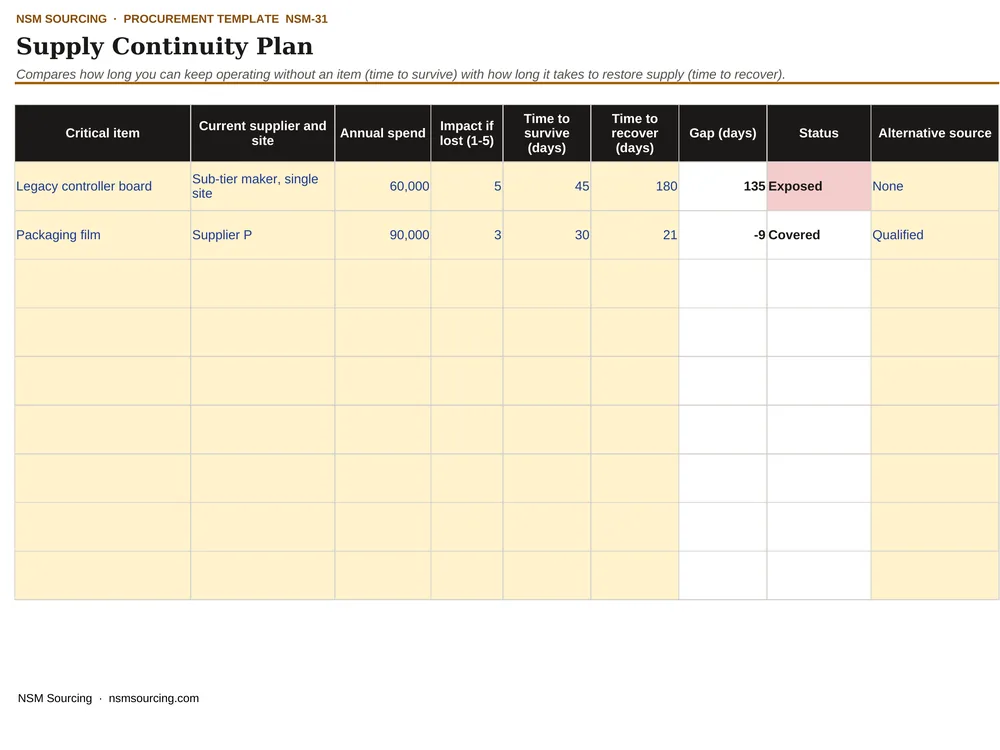

    Supply Continuity Plan

    Compare time to survive with time to recover, and plan the response before a disruption.

    Download

Engage and qualify suppliers

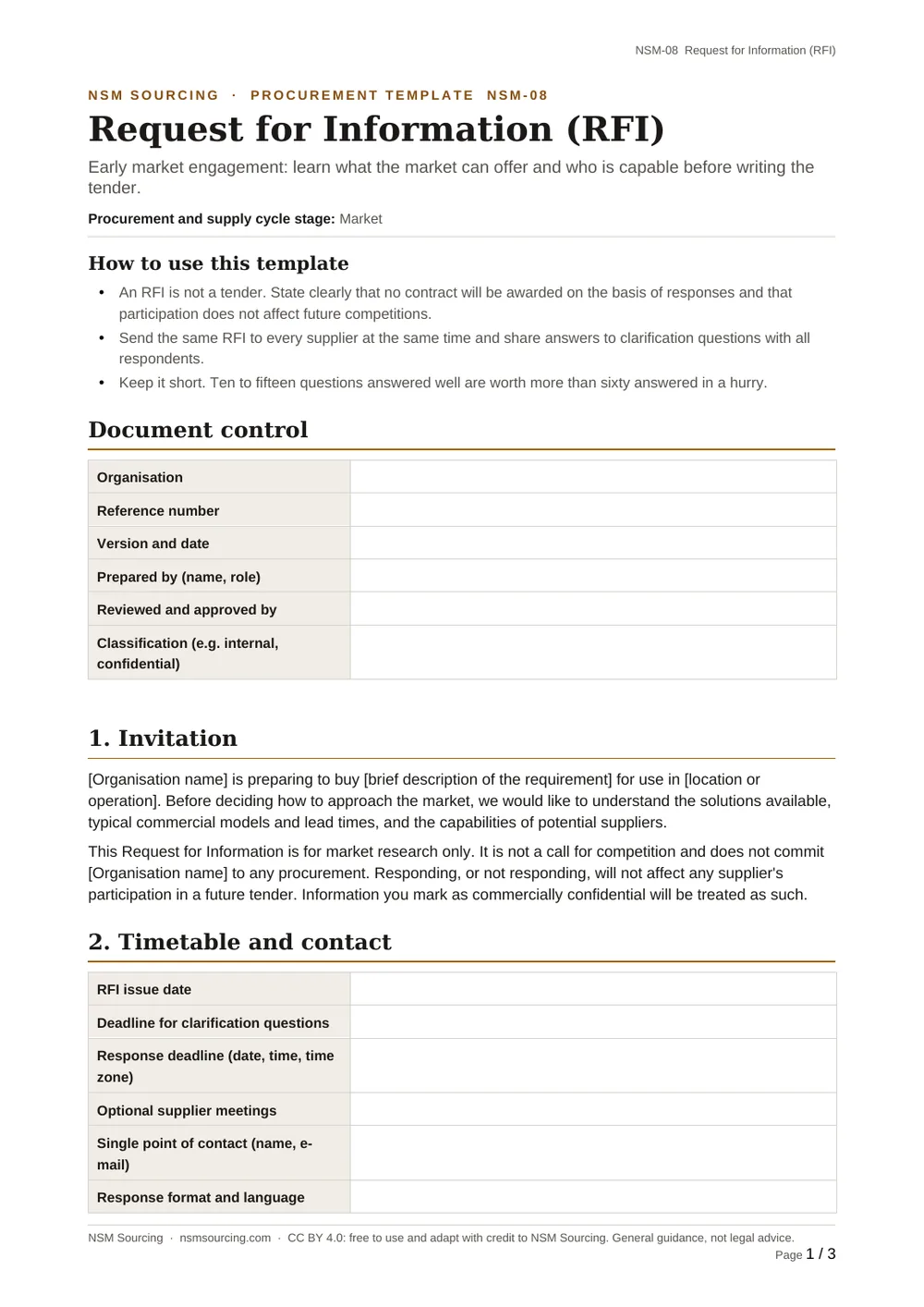

  • 08Word

    Request for Information (RFI)

    Engage the market before the tender documents are written.

    Download

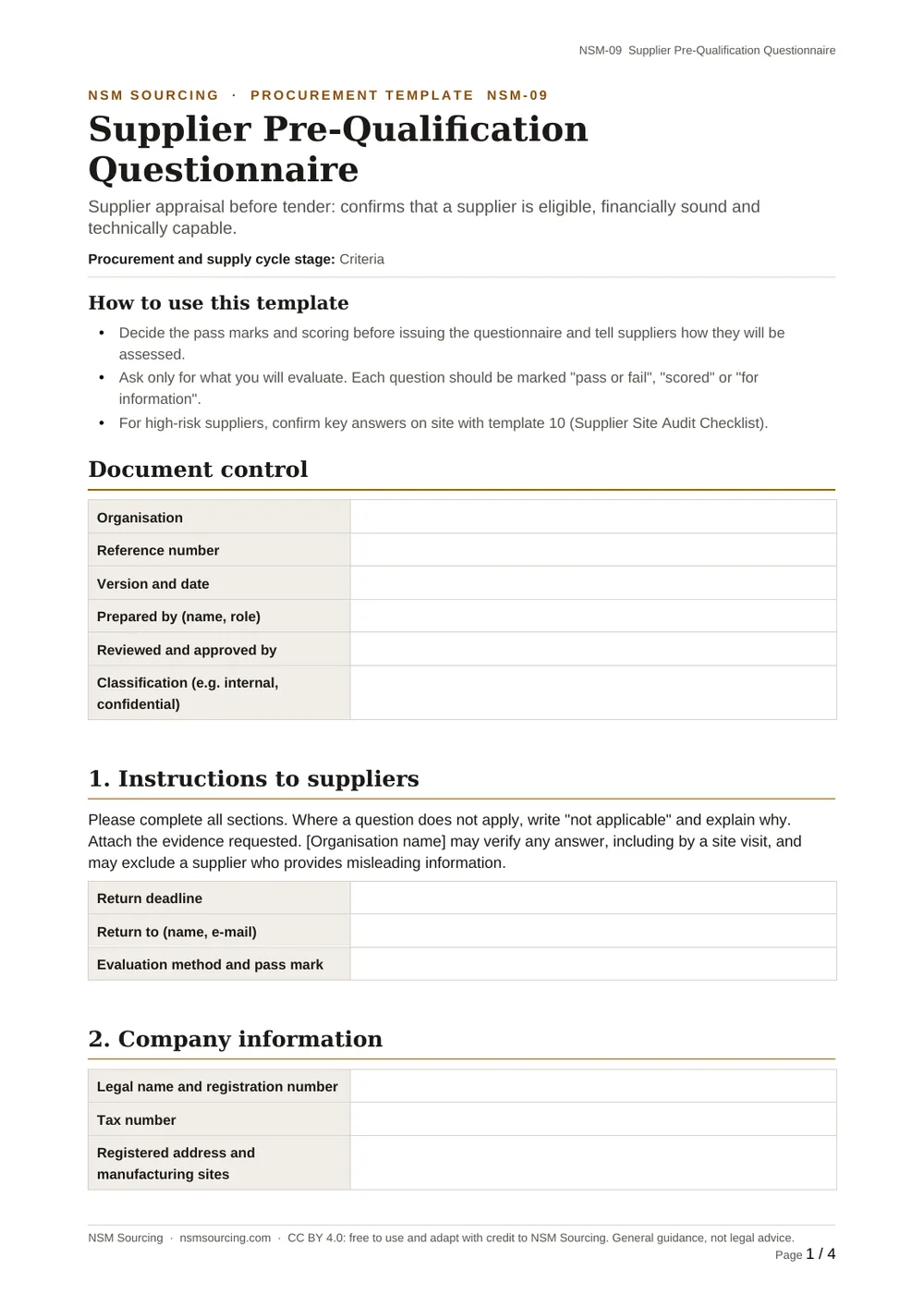

  • 09Word

    Supplier Pre-Qualification Questionnaire

    Confirm eligibility, financial standing, capability, resilience and compliance.

    Download

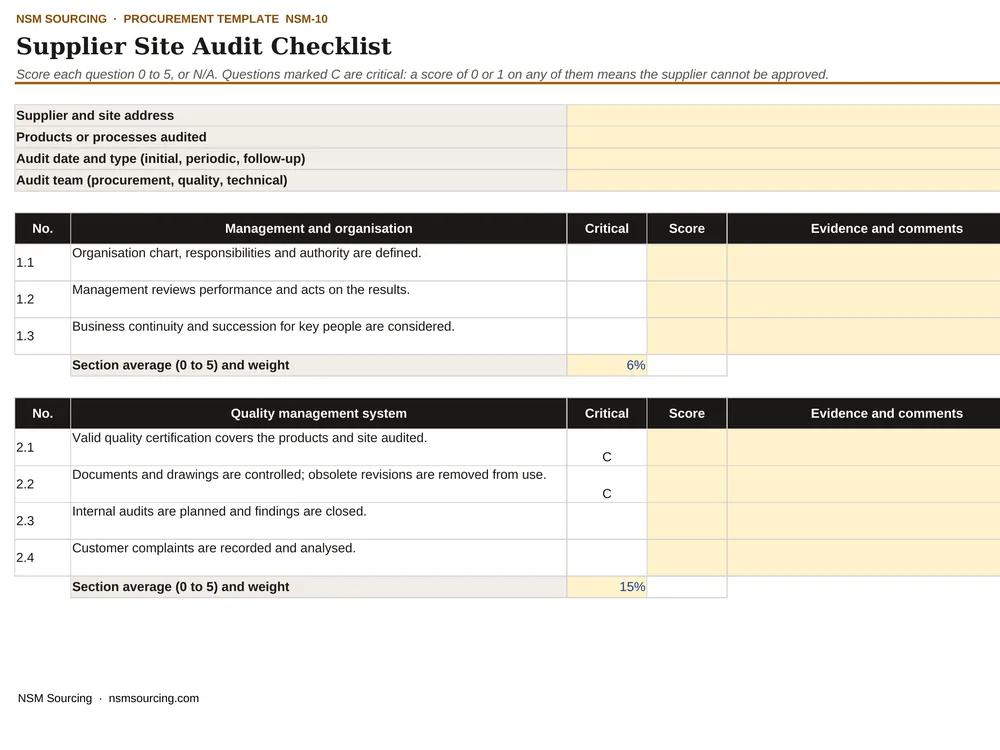

  • 10Excel

    Supplier Site Audit Checklist

    A scored on-site audit, including business continuity and information security.

    Download

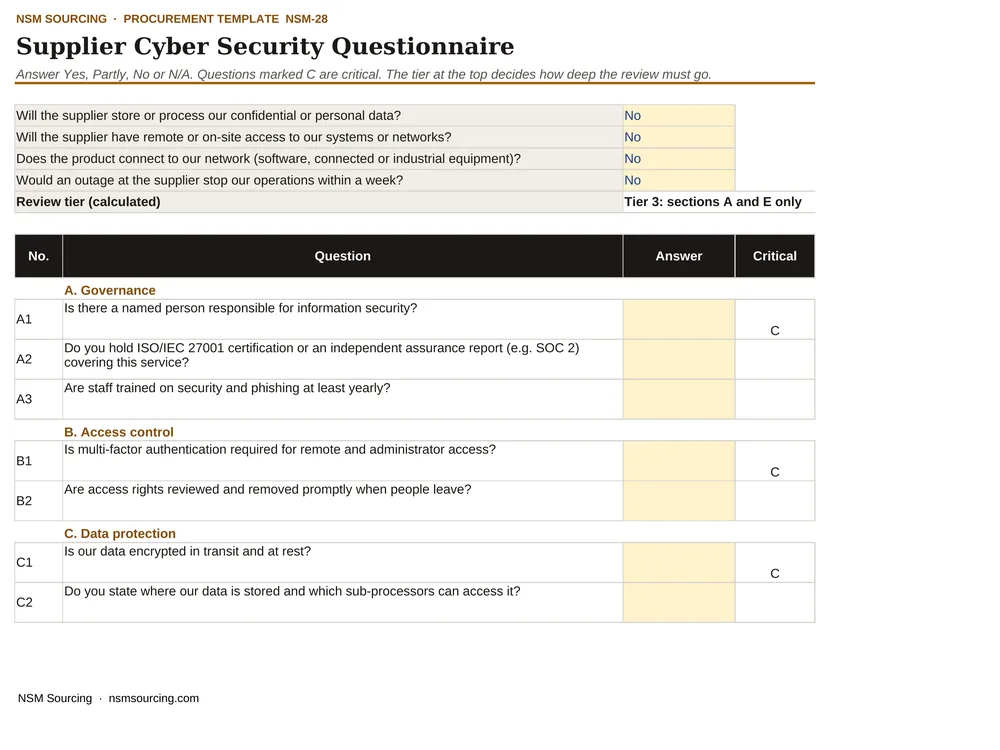

  • 28Excel

    Supplier Cyber Security Questionnaire

    Security questions in proportion to the supplier's risk tier, with critical questions and a score.

    Download
  • 30Excel

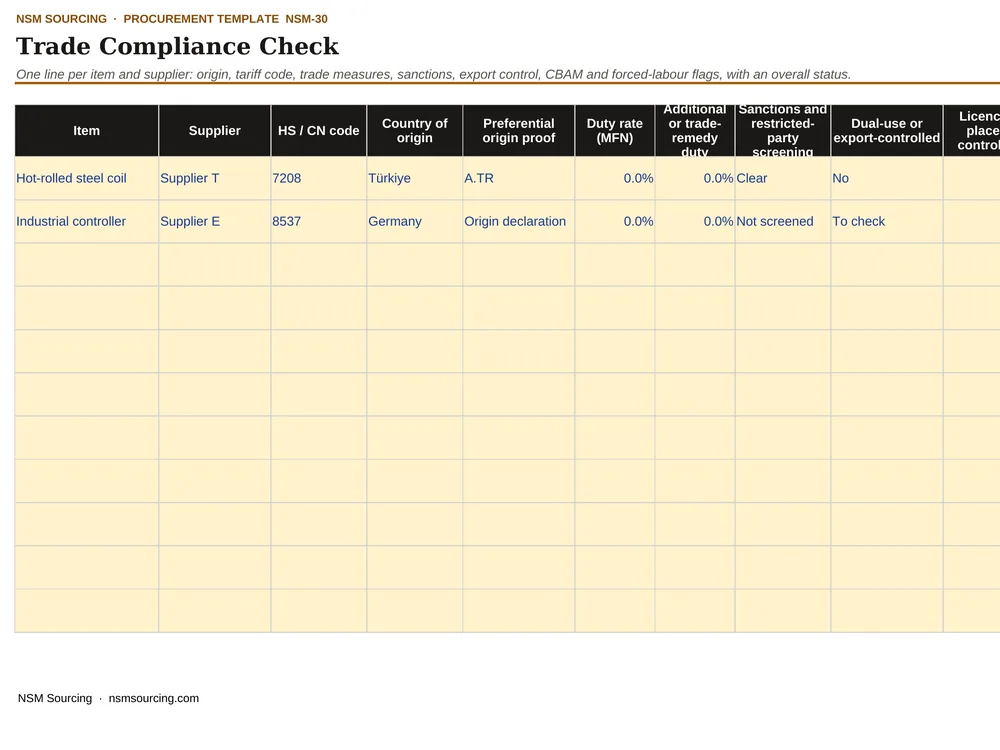

    Trade Compliance Check

    Sanctions screening, origin, export control, CBAM and forced labour checks in one register.

    Download

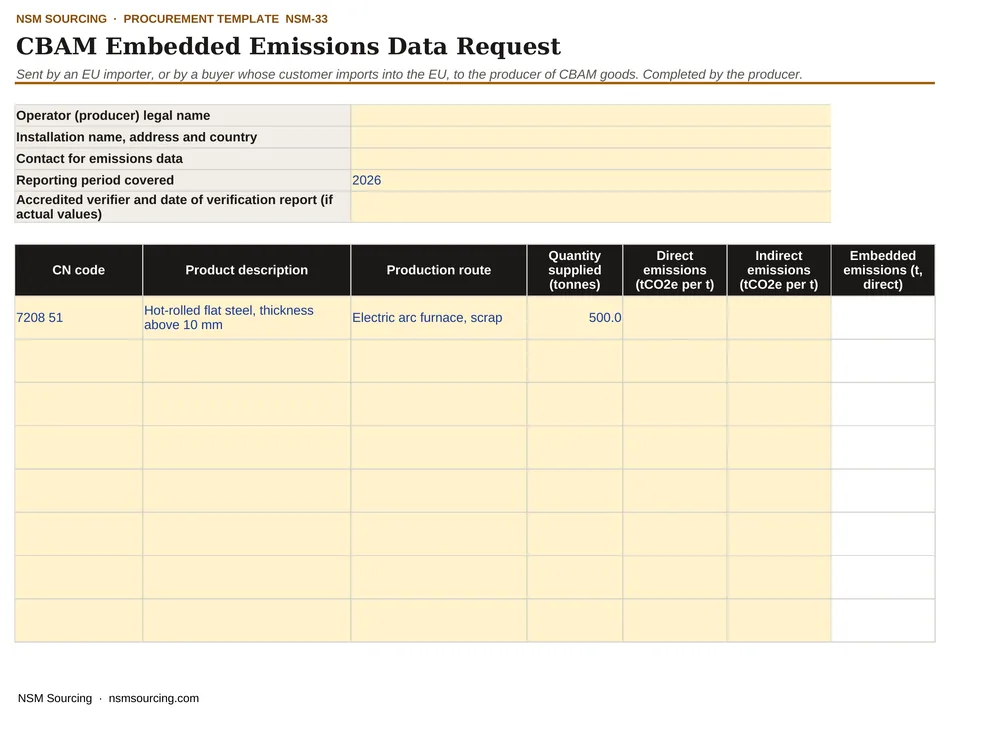

  • 33Excel

    CBAM Embedded Emissions Data Request

    Request installation and product emissions data from suppliers of CBAM goods.

    Download

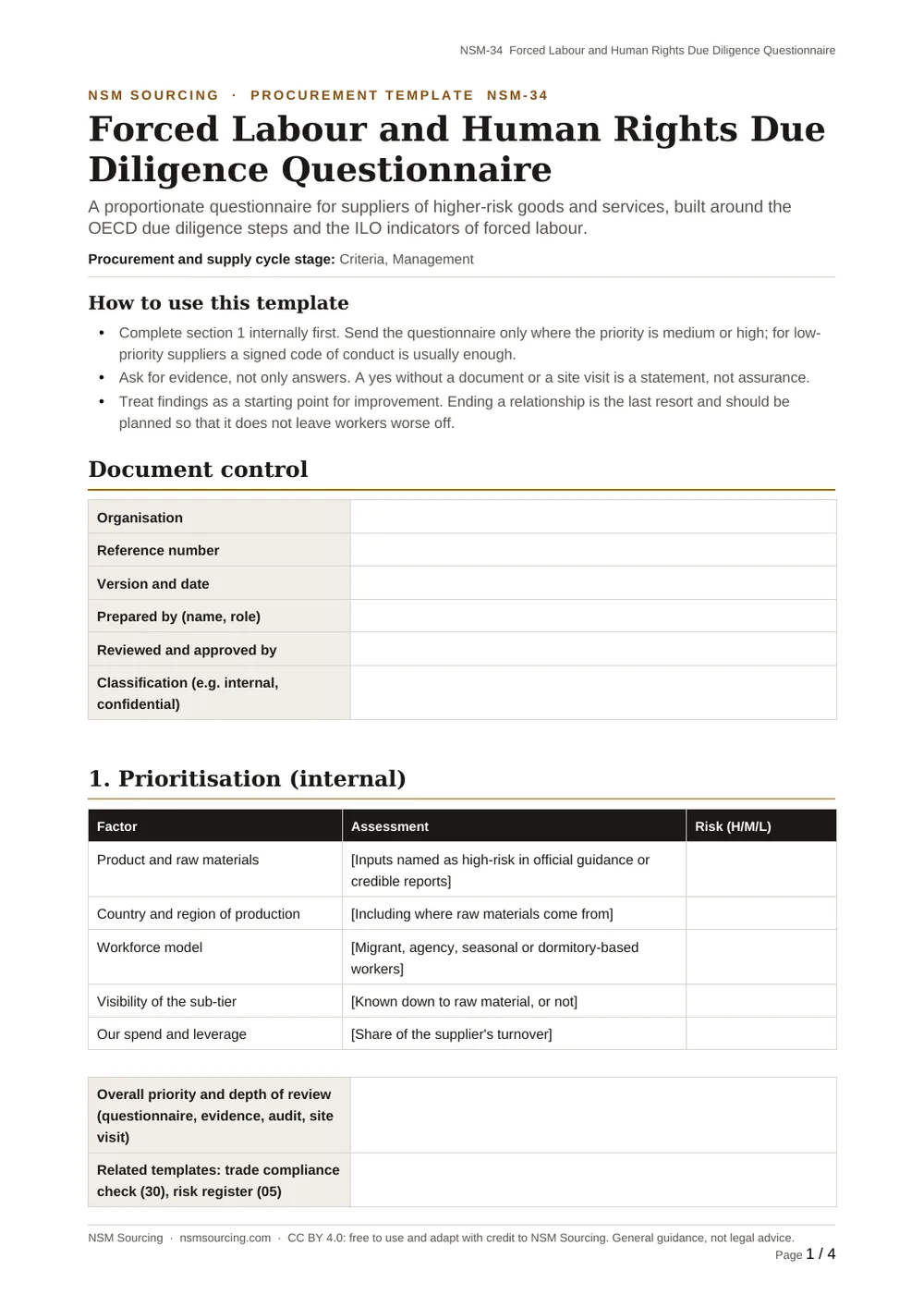

  • 34Word

    Forced Labour and Human Rights Due Diligence Questionnaire

    A proportionate questionnaire built on the OECD due diligence steps and the ILO indicators of forced labour.

    Download

Tender, evaluate and negotiate

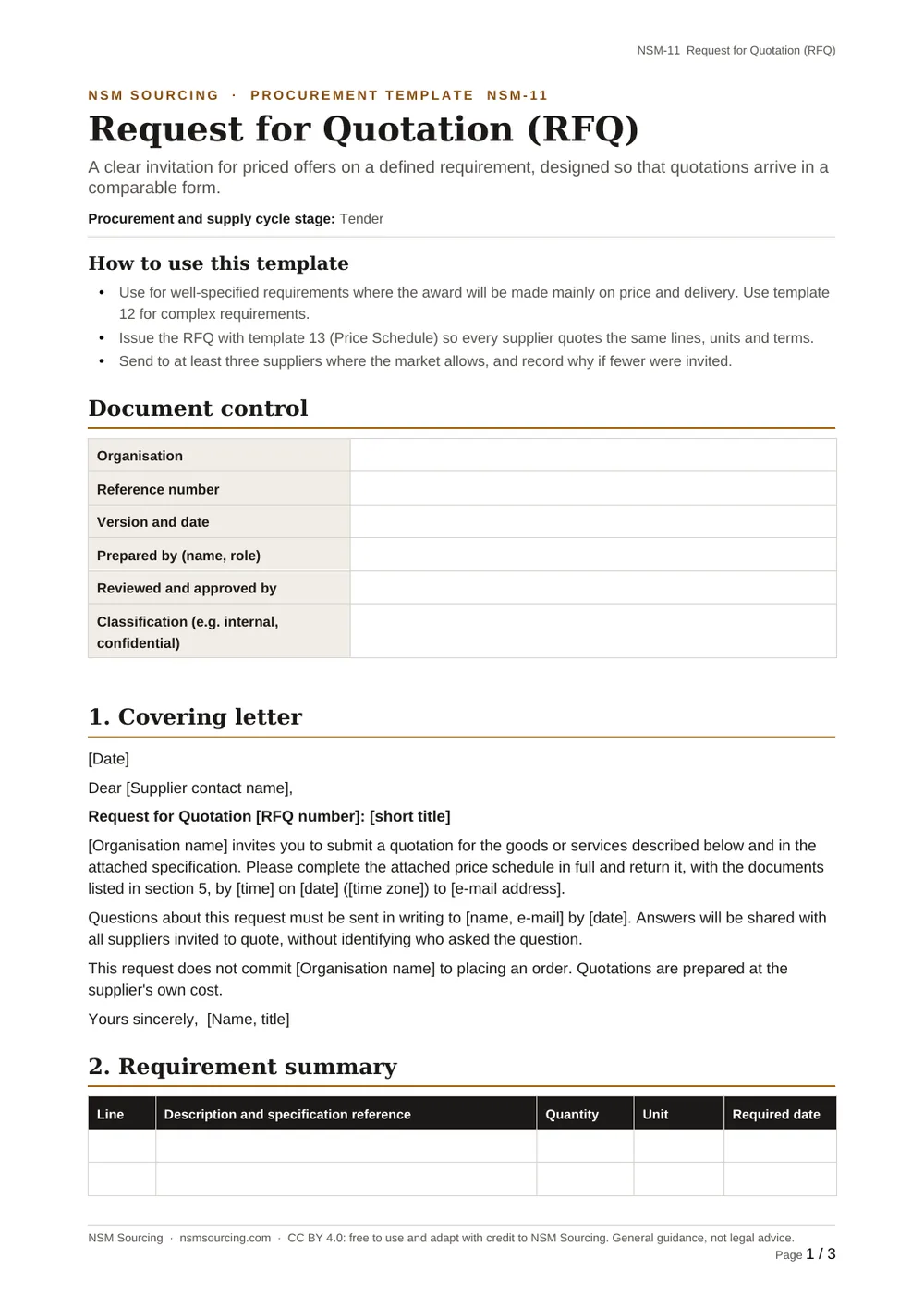

  • 11Word

    Request for Quotation (RFQ)

    An invitation to quote, designed so that quotations arrive in comparable form.

    Download

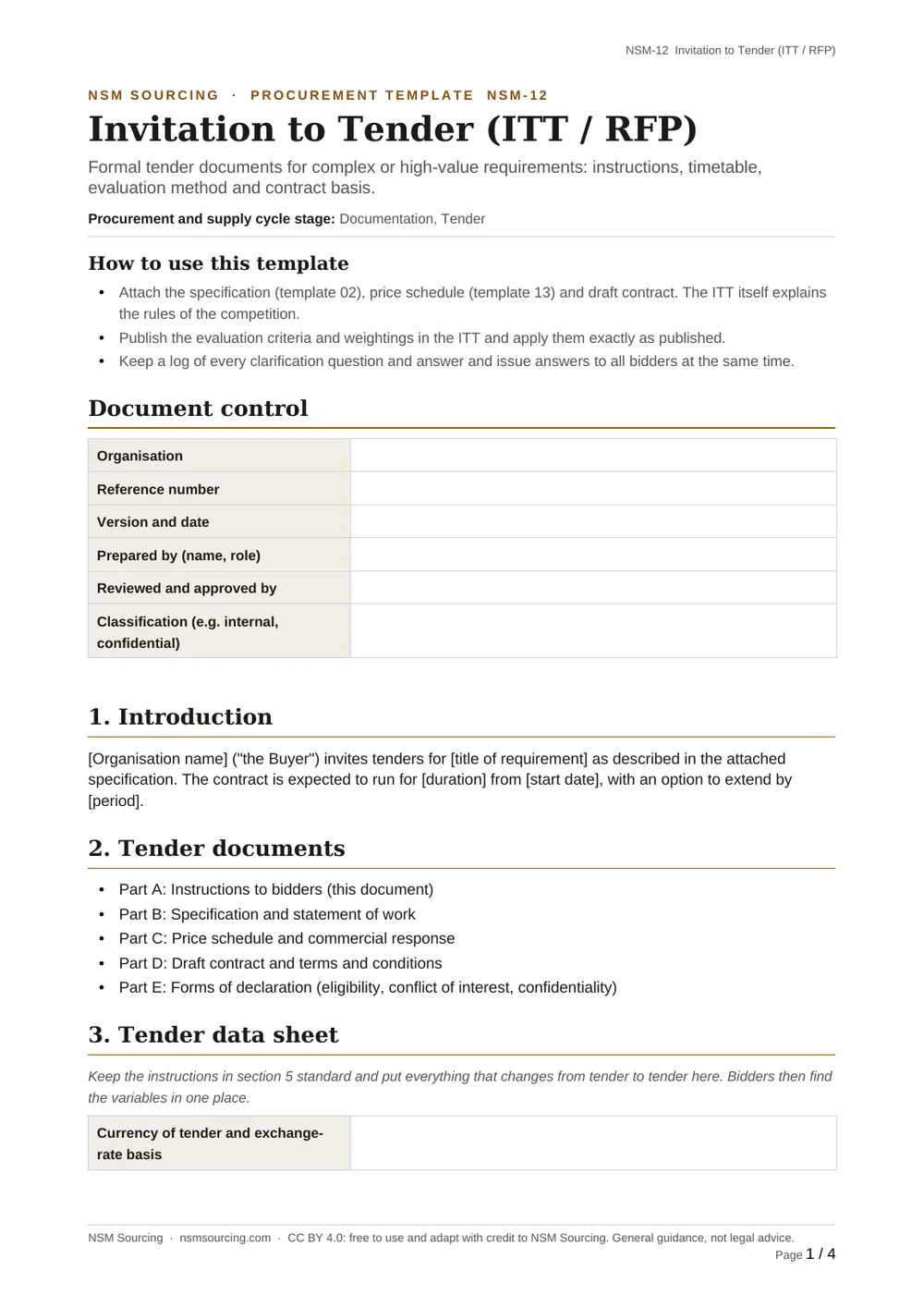

  • 12Word

    Invitation to Tender (ITT / RFP)

    Formal tender documents: instructions, tender data sheet, evaluation method and contract basis.

    Download

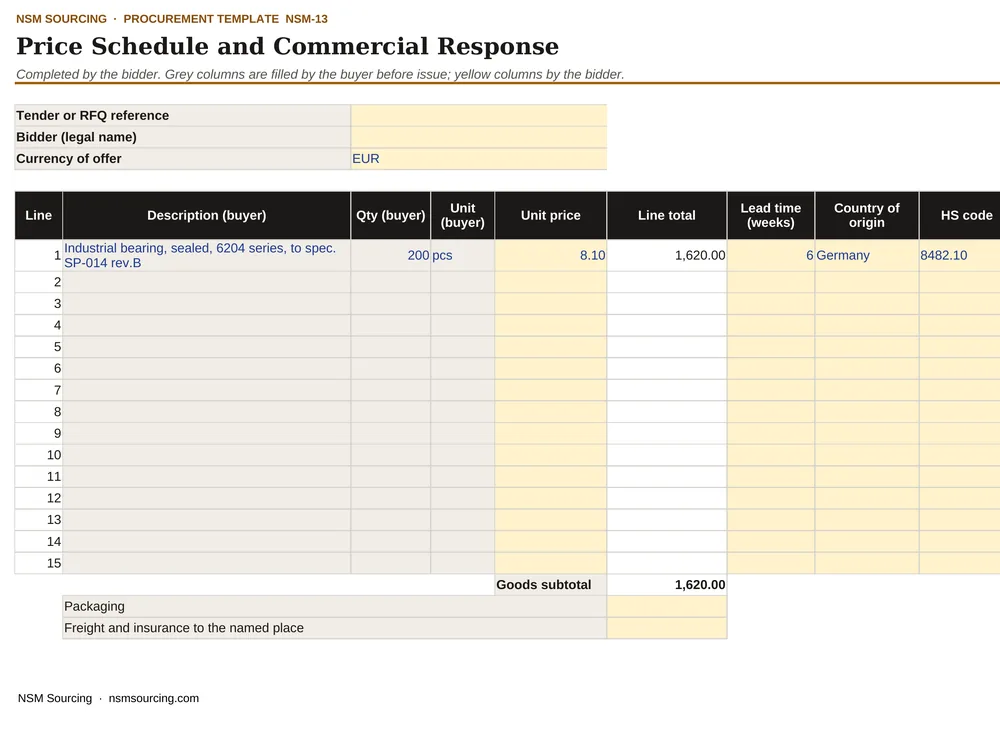

  • 13Excel

    Price Schedule and Commercial Response

    One format for every bidder's prices, terms, origin and freight.

    Download

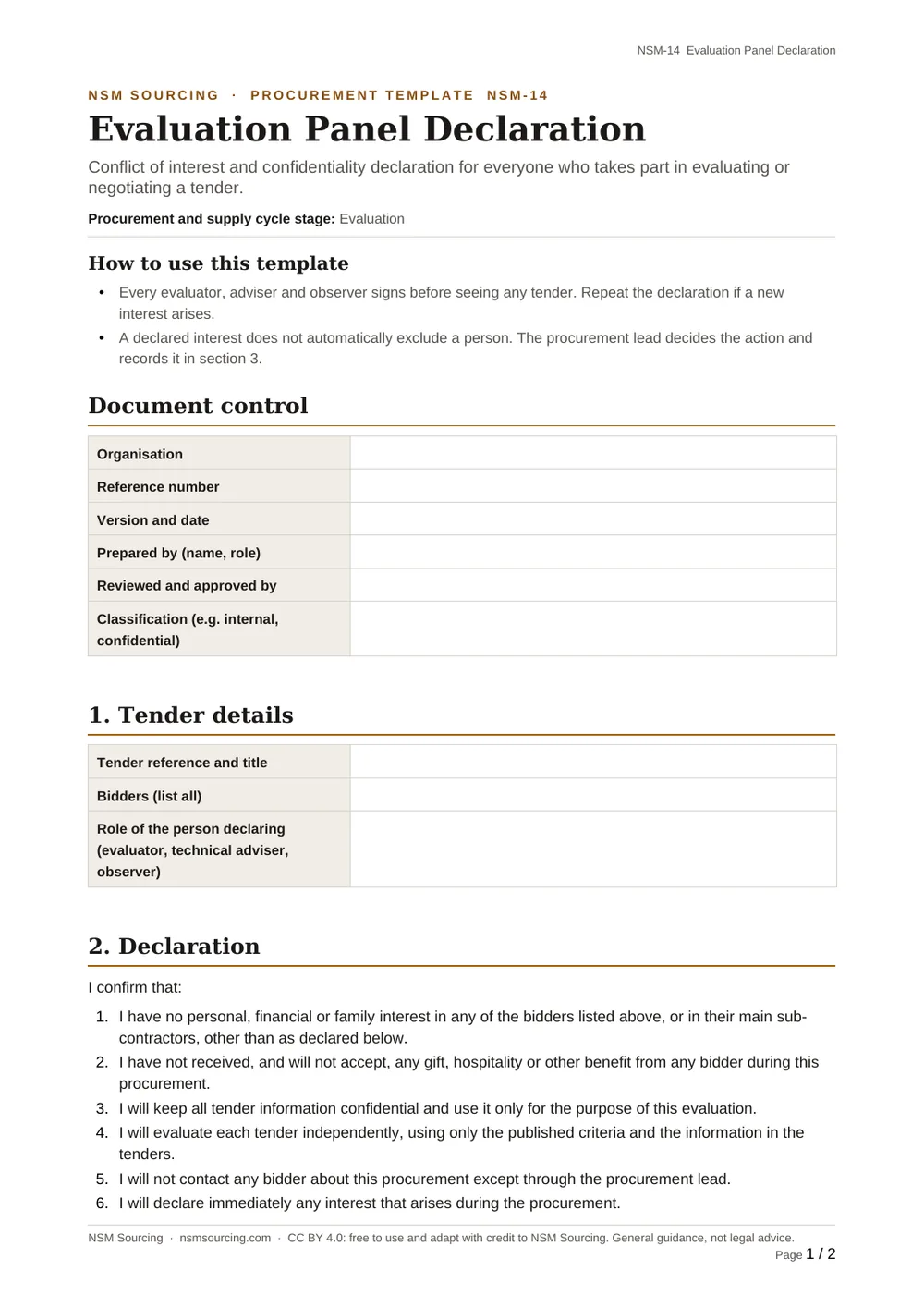

  • 14Word

    Evaluation Panel Declaration

    Conflict of interest and confidentiality declaration for everyone involved in evaluation.

    Download

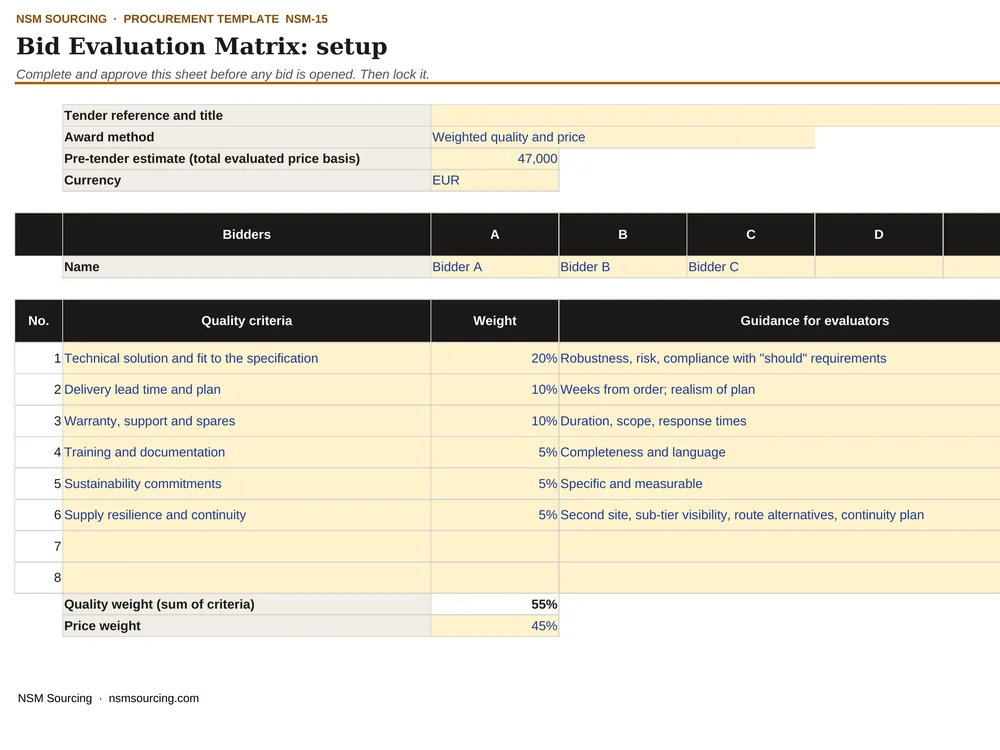

  • 15Excel

    Bid Evaluation Matrix

    Weighted quality and price scoring, with an abnormally low tender check.

    Download
  • 16Excel

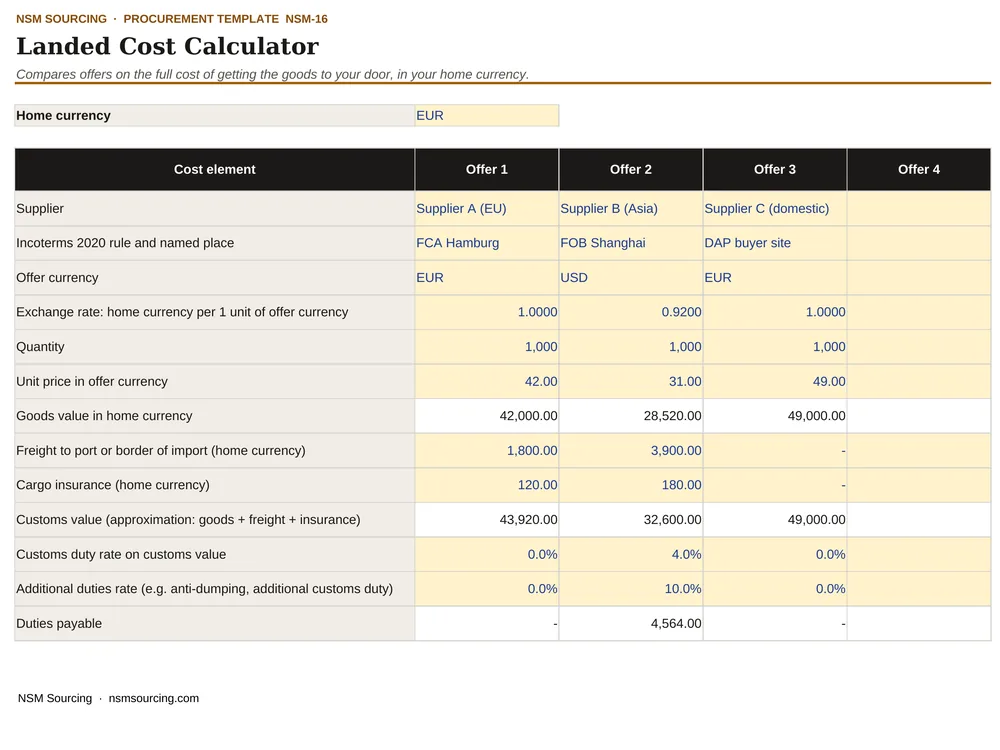

    Landed Cost and TCO Calculator

    Compare offers on landed cost and total cost of ownership, with freight, tariff and CBAM scenarios.

    Download
  • 17Word

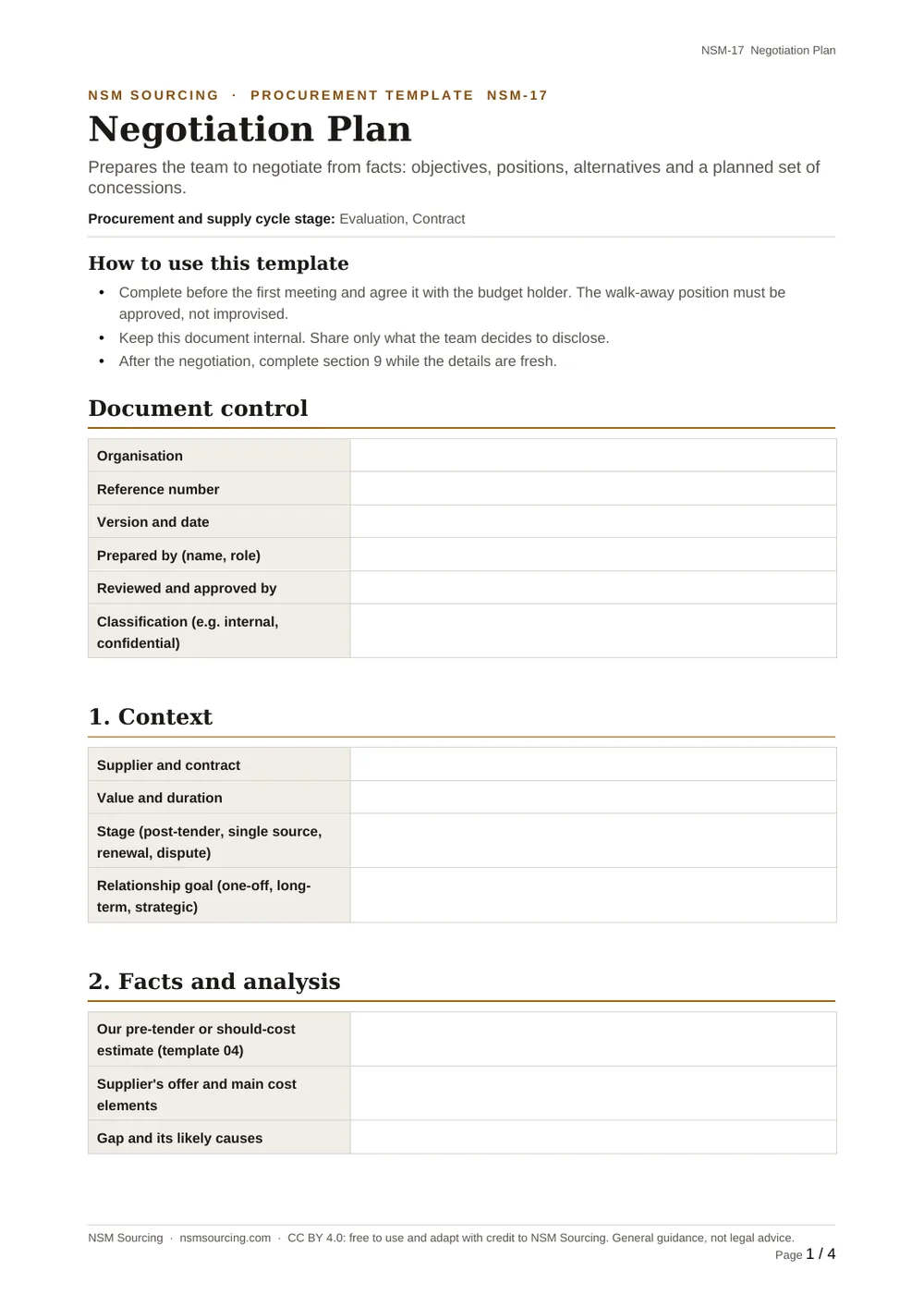

    Negotiation Plan

    Objectives, positions, alternatives and planned concessions, agreed before the first meeting.

    Download

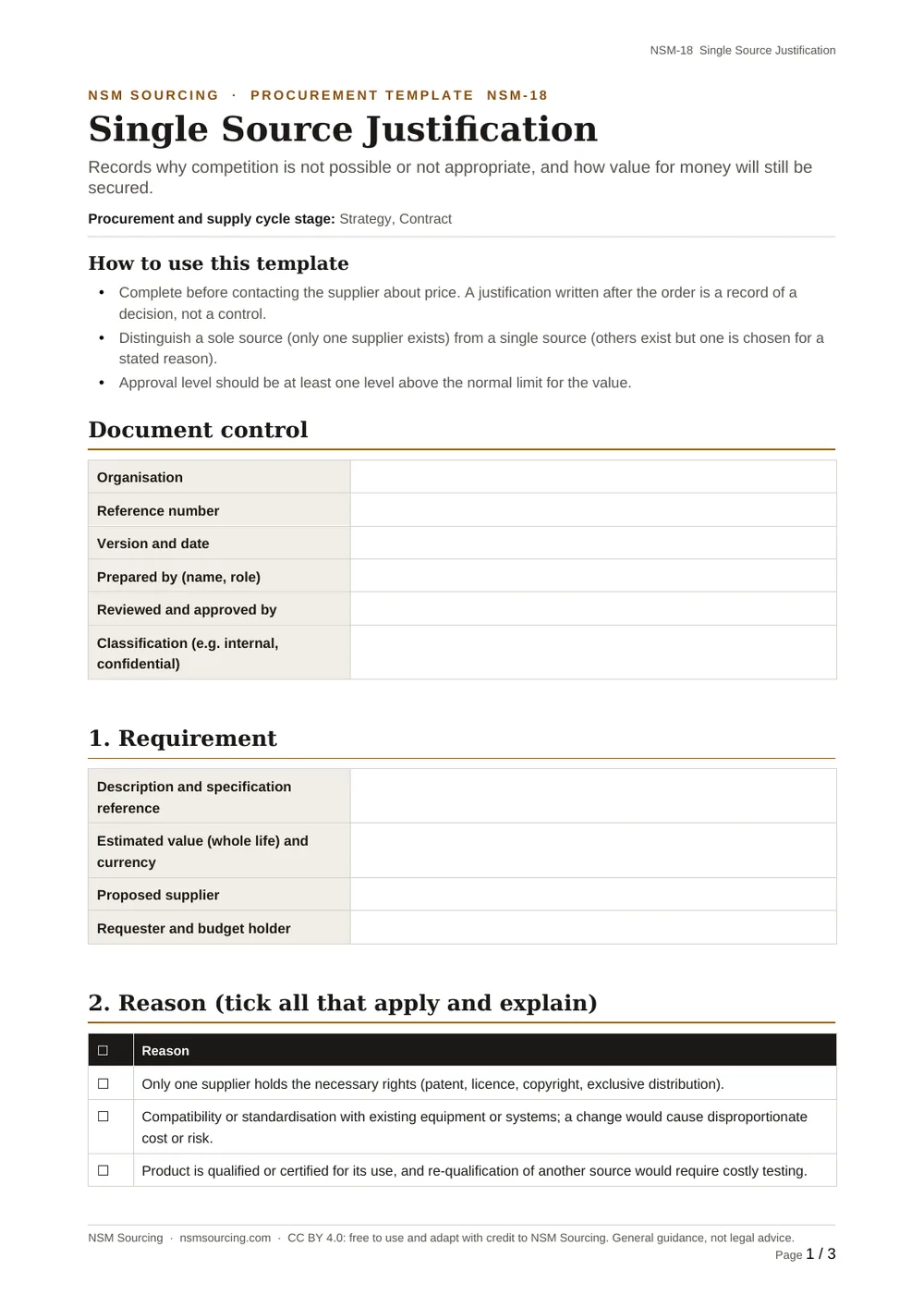

  • 18Word

    Single Source Justification

    Record why competition is not possible and how value will still be secured.

    Download

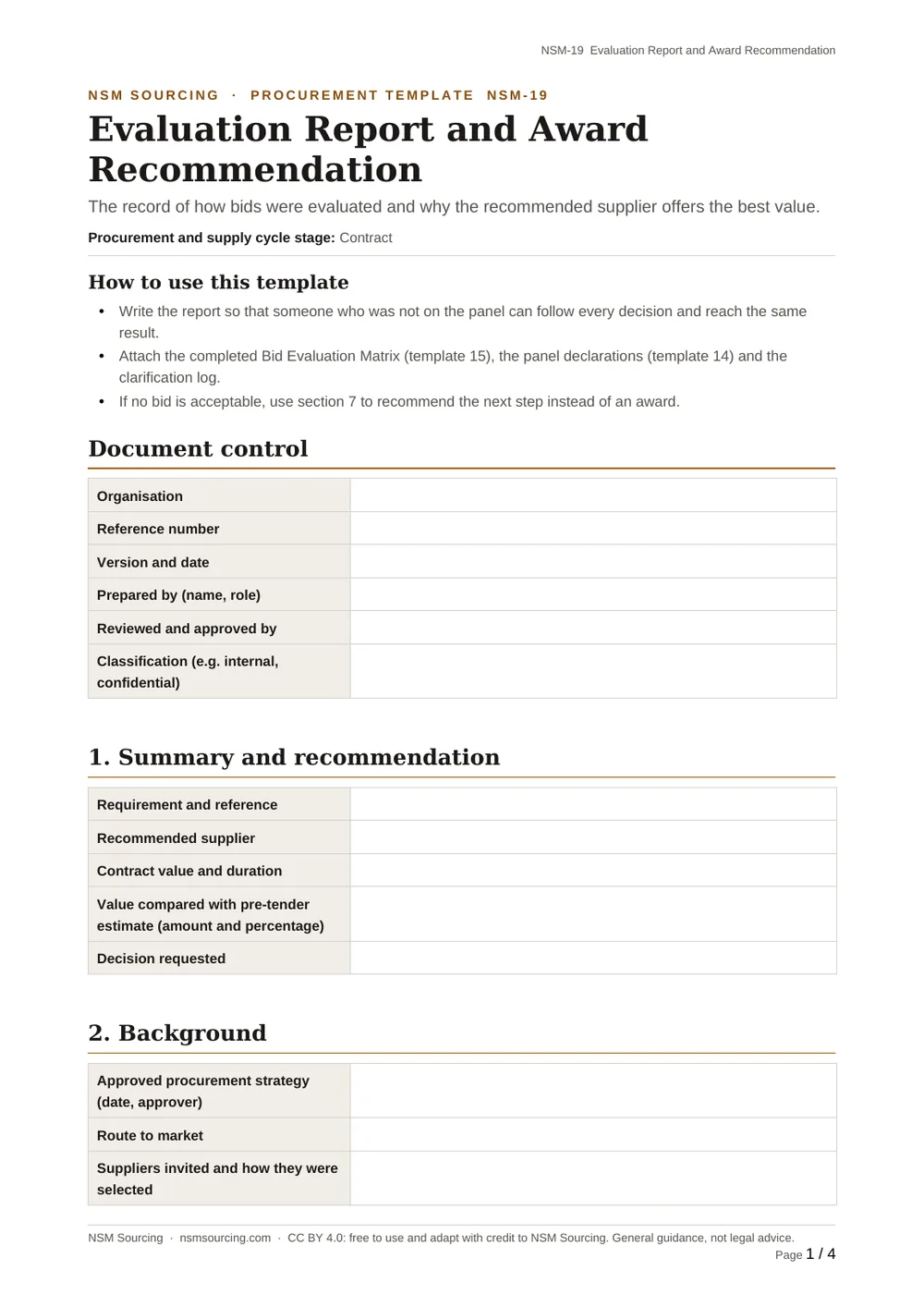

  • 19Word

    Evaluation Report and Award Recommendation

    A record of the evaluation that someone outside the panel can follow.

    Download

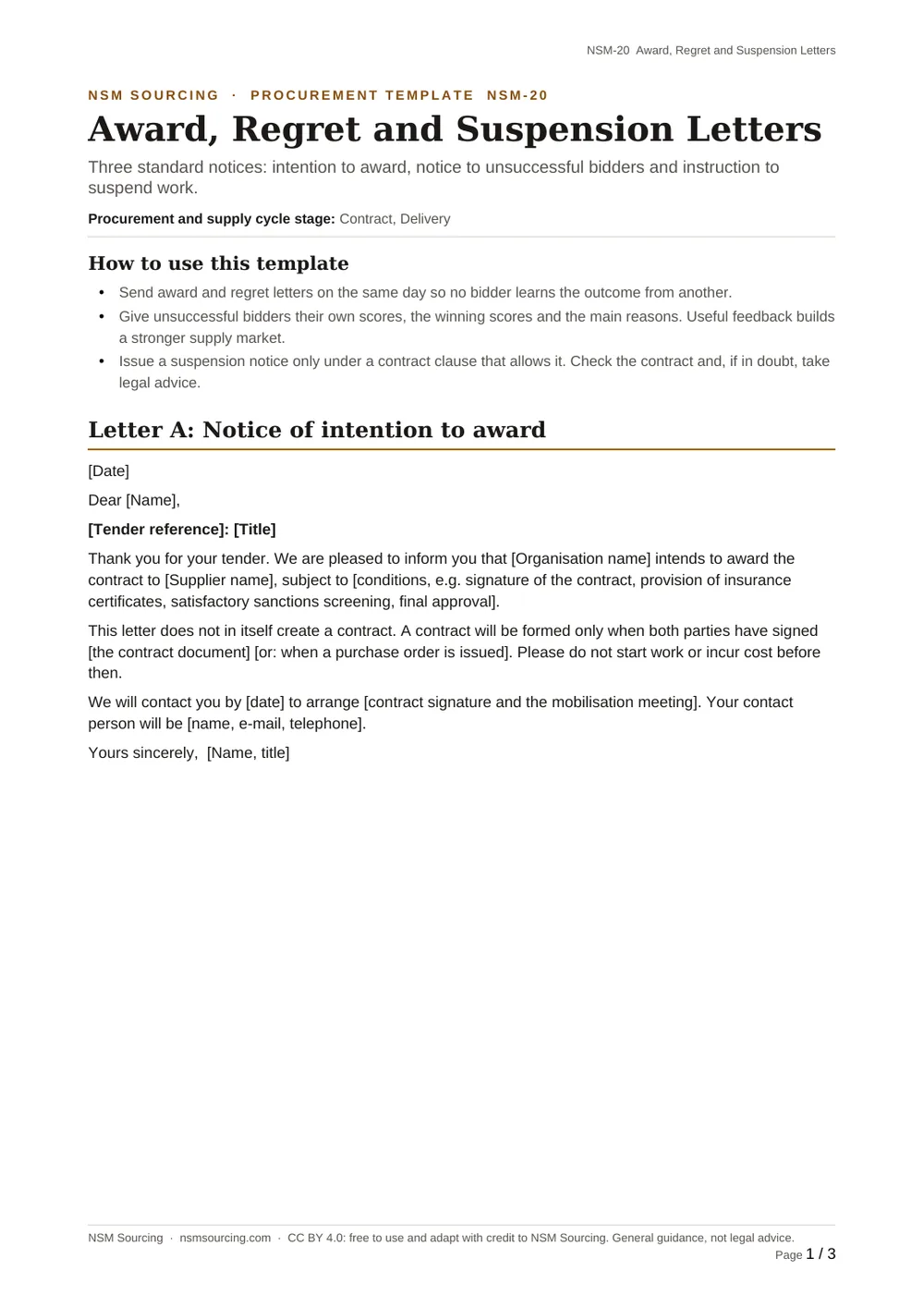

  • 20Word

    Award, Regret and Suspension Letters

    Three standard letters: intention to award, notice to unsuccessful bidders and suspension of work.

    Download

Contract and manage performance

  • 21Excel

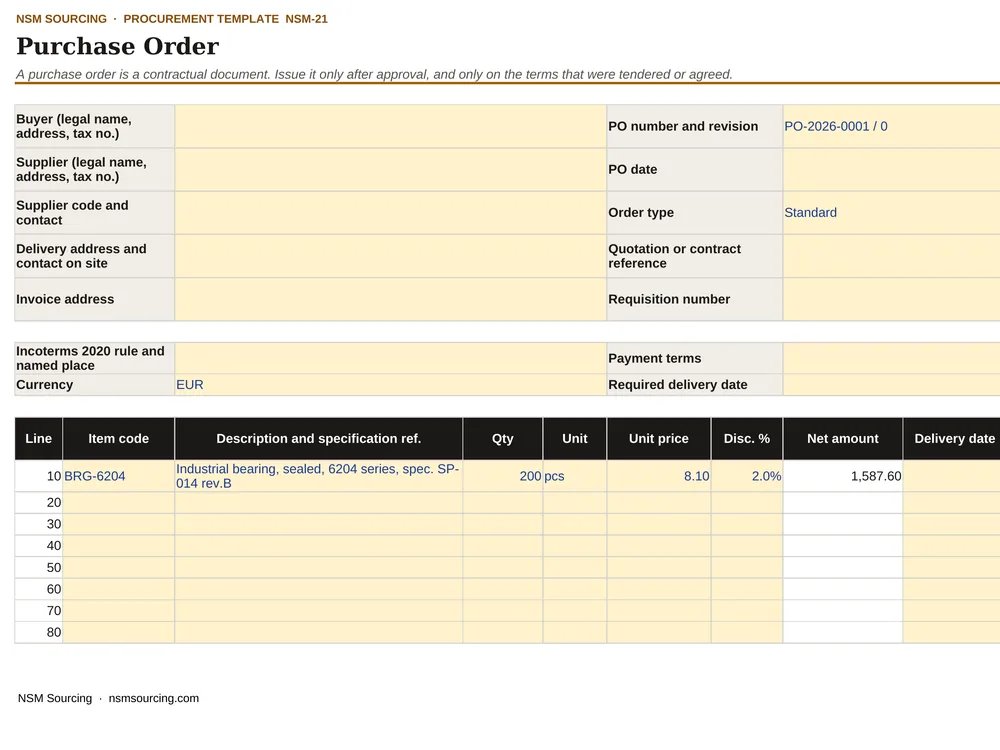

    Purchase Order

    A purchase order with key conditions and a checklist to complete before it is issued.

    Download

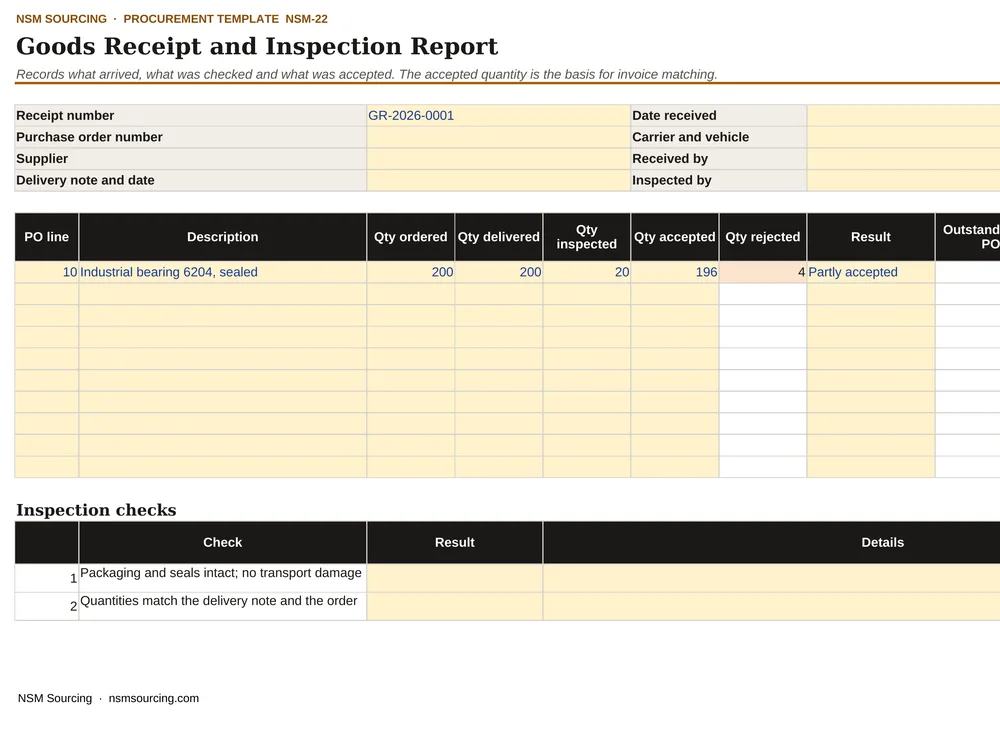

  • 22Excel

    Goods Receipt and Inspection Report

    Receiving inspection, including origin documents and CBAM data.

    Download
  • 23Excel

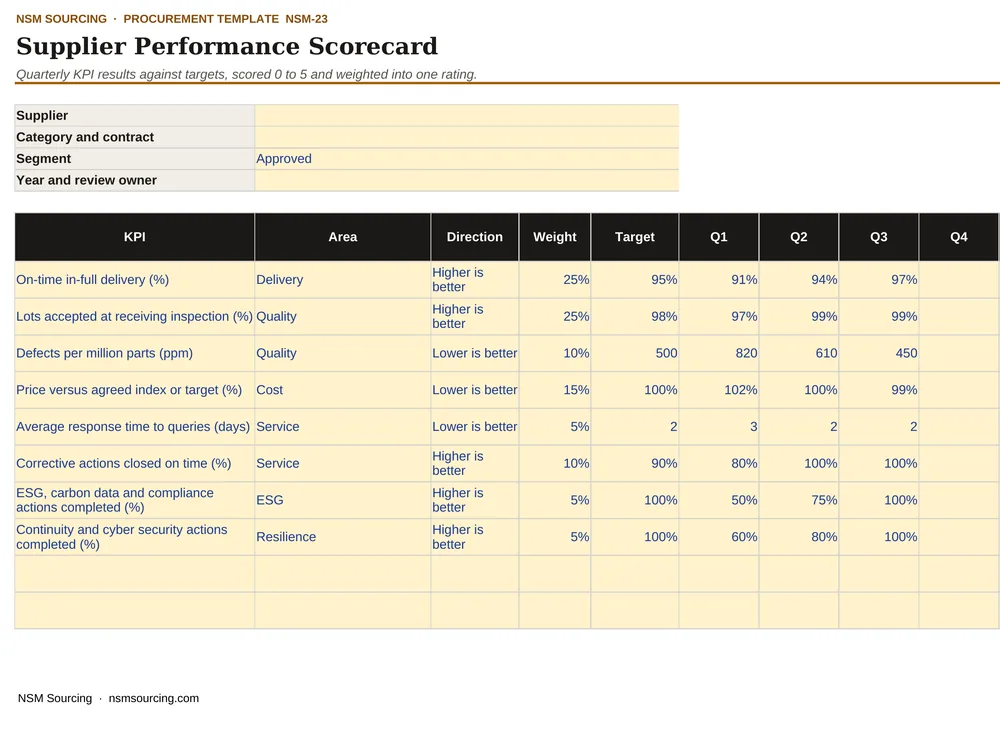

    Supplier Performance Scorecard

    Weighted KPIs for delivery, quality, cost, service, ESG and resilience.

    Download
  • 24Word

    Non-Conformance and Corrective Action Request

    Record a non-conformance and require containment, root cause analysis and corrective action.

    Download
  • 25Excel

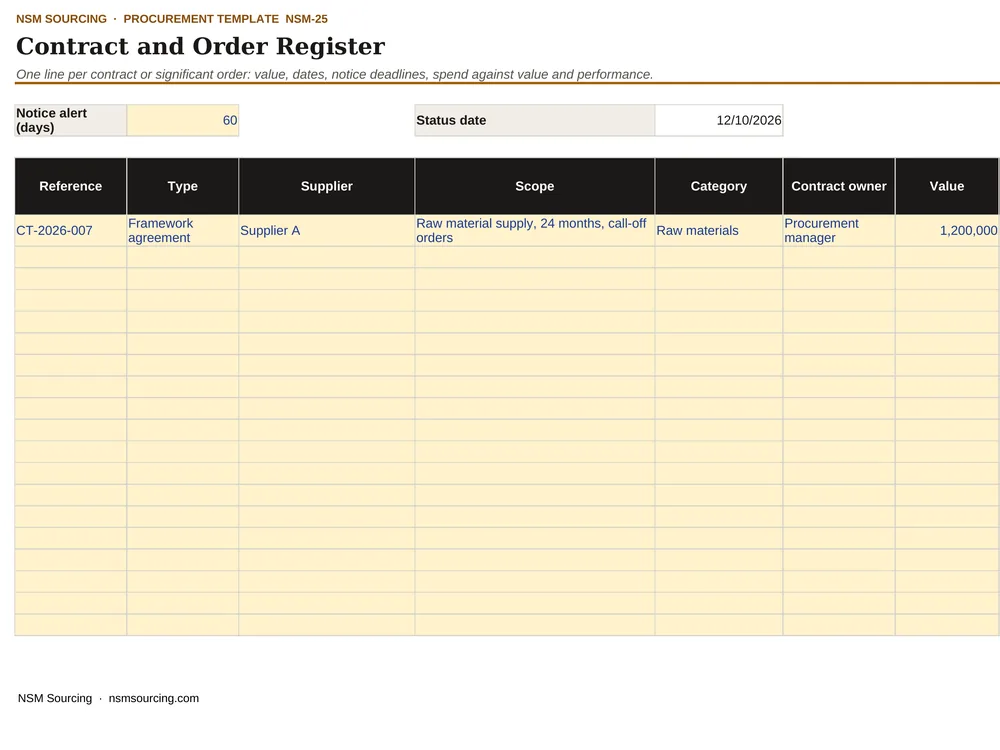

    Contract and Order Register

    Track contracts, notice deadlines, price reviews and sanctions re-screening dates.

    Download
  • 32Excel

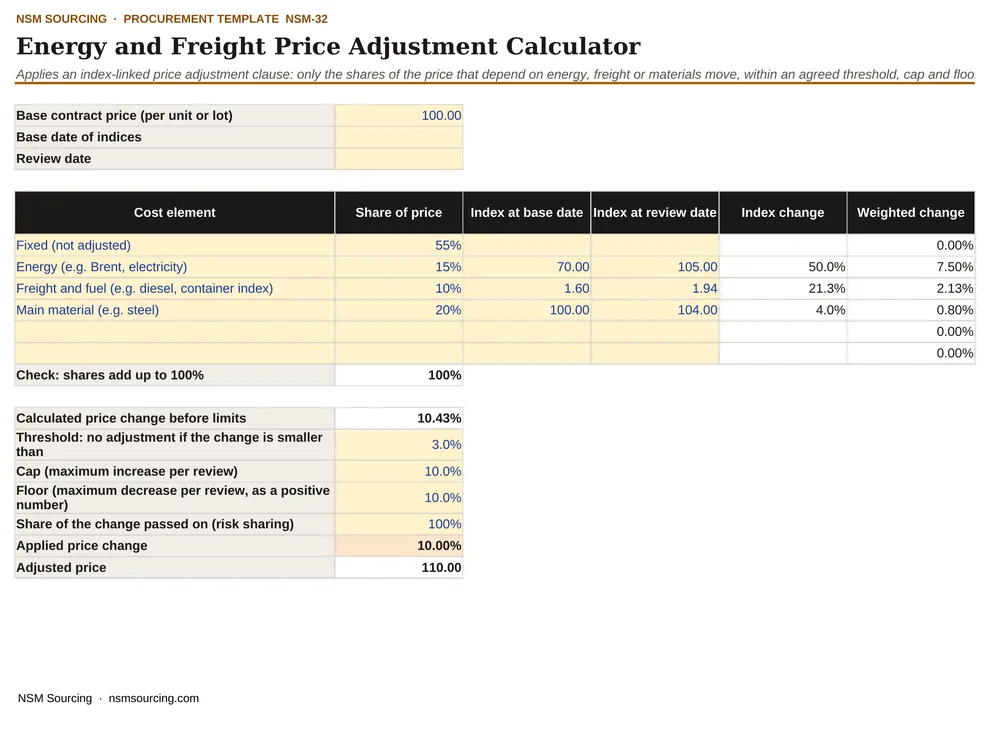

    Energy and Freight Price Adjustment Calculator

    Apply an agreed index formula with threshold, cap and floor, and check surcharge claims.

    Download

  • 35Excel

    Contract Compliance and Value Leakage Check

    Check invoices against contract prices and track contractual obligations.

    Download

AI in procurement

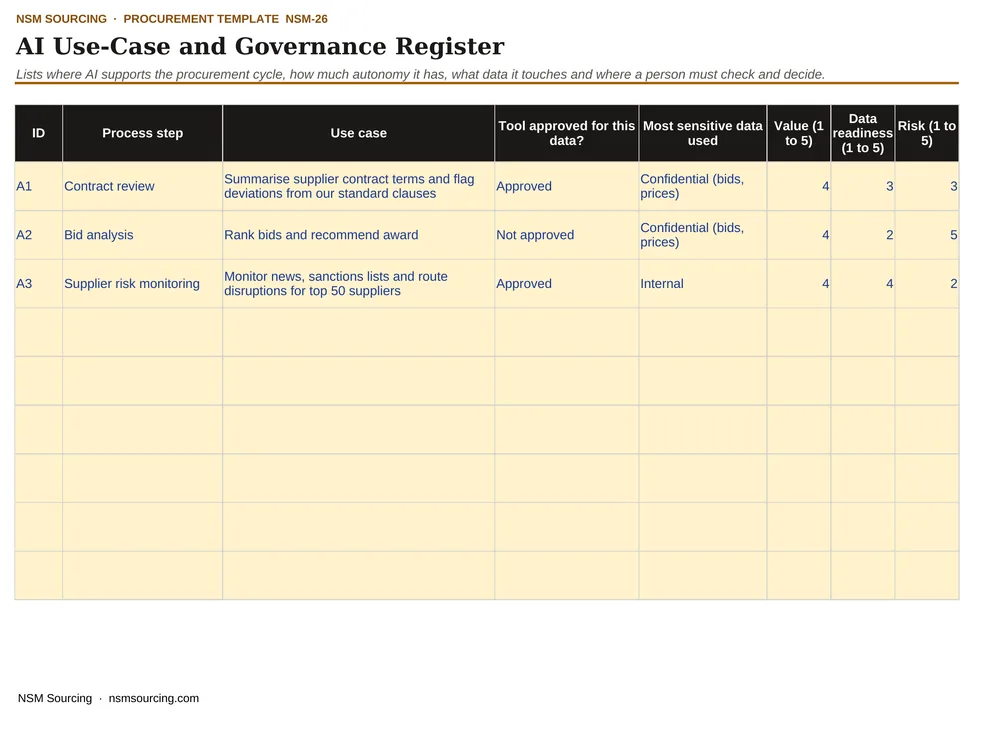

  • 26Excel

    AI Use-Case and Governance Register

    Record where AI is used, with which data and controls, and where a person checks the output.

    Download

  • 27Word

    AI Tool Procurement: Supplier Questionnaire and Contract Checklist

    Questions, evidence and contract clauses for buying AI tools and services.

    Download

About these templates

The templates follow the structure and terminology of the CIPS Procurement and Supply Cycle. They are an independent work by NSM Sourcing and are not endorsed by CIPS.

Each template is short, uses the language of the profession and is written for private-sector buyers. Facts about regulations and markets are stated as of October 2026; check them before relying on them. The templates are general guidance, not legal advice.

The templates are published under the Creative Commons Attribution 4.0 International licence (CC BY 4.0). You may copy, adapt and share them, including for commercial purposes, provided you credit NSM Sourcing as the source.

CC BY 4.0 licence

Want help adapting them to your organisation?
